PK/PD and multiple endpoints

Where you are

So far every model had one endpoint, a drug concentration. Pharmacodynamic (PD) models describe a response. They can be linked to the pharmacokinetics and fitted together with the concentrations, used to compute a predicted effect from a PK fit, or stand on their own as an equation of time or dose. This chapter covers all three with the bundled examples.

WarningMaturity: stable, beta and experimental parts

The error models are stable in ferx-core. ODE models, [scaling] and [derived] are beta. Compartment-free models are documented in the ferx-core structural model page. See feature maturity.

The data

emax_pkpd has 3 subjects with an oral dose, plasma concentrations and effect measurements in one dataset. The CMT column tells the endpoints apart: 2 for the concentration, 3 for the effect:

pkpd <- ferx_example("emax_pkpd")
pkpd_dir <- book_tempdir("pkpd")
pkpd_data <- read.csv(pkpd$data, na.strings = ".")
filter(pkpd_data, ID == 1) |> arrange(CMT, TIME)
#>    ID TIME   DV EVID AMT CMT RATE MDV
#> 1   1  0.0   NA    1 100   1    0   1
#> 2   1  0.5  7.8    0  NA   2    0   0
#> 3   1  1.0  9.5    0  NA   2    0   0
#> 4   1  2.0  8.1    0  NA   2    0   0
#> 5   1  4.0  5.2    0  NA   2    0   0
#> 6   1  8.0  2.1    0  NA   2    0   0
#> 7   1  1.0 12.4    0  NA   3    0   0
#> 8   1  2.0 21.7    0  NA   3    0   0
#> 9   1  4.0 28.3    0  NA   3    0   0
#> 10  1  8.0 24.9    0  NA   3    0   0
count(filter(pkpd_data, EVID == 0), CMT)
#>   CMT  n
#> 1   2 15
#> 2   3 12

Minimal runnable call: a joint PK/PD fit

The model has three ODE states: the depot, the central compartment and an effect compartment that follows the plasma concentration with rate KE0. [scaling] gives one readout per observed CMT (Observation scaling with [scaling]), and [error_model] one residual error model per CMT:

invisible(ferx_model_get_section(pkpd$model, "odes"))
#> # [odes]
#>   d/dt(depot)   = -KA * depot
#>   d/dt(central) =  KA * depot - CL/V * central
#>   d/dt(effect)  =  KE0 * (central/V - effect)
invisible(ferx_model_get_section(pkpd$model, "scaling"))
#> # [scaling]
#>   y[CMT=2] = central / V                                  # plasma conc (mg/L)
#>   y[CMT=3] = E0 + EMAX * effect^GAMMA / (EC50^GAMMA + effect^GAMMA)  # Emax PD
invisible(ferx_model_get_section(pkpd$model, "error_model"))
#> # [error_model]
#>   CMT=2: DV ~ proportional(PROP_ERR_PK)   # central compartment (PK)
#>   CMT=3: DV ~ additive(ADD_ERR_PD)        # effect compartment (PD)
fit_pkpd <- ferx_fit(pkpd$model, pkpd$data, verbose = FALSE)

Both endpoints enter one likelihood, so the PK and PD parameters are estimated together.

Reading the result

sdtab keeps the CMT column, so each endpoint can be plotted separately:

fit_pkpd$sdtab |>
  mutate(endpoint = ifelse(CMT == 2, "Concentration (CMT 2)", "Effect (CMT 3)")) |>
  ggplot(aes(TIME, colour = factor(ID))) +
  geom_point(aes(y = DV)) +
  geom_line(aes(y = IPRED)) +
  facet_wrap(~ endpoint, scales = "free_y") +
  labs(x = "Time (h)", y = NULL, colour = "ID")

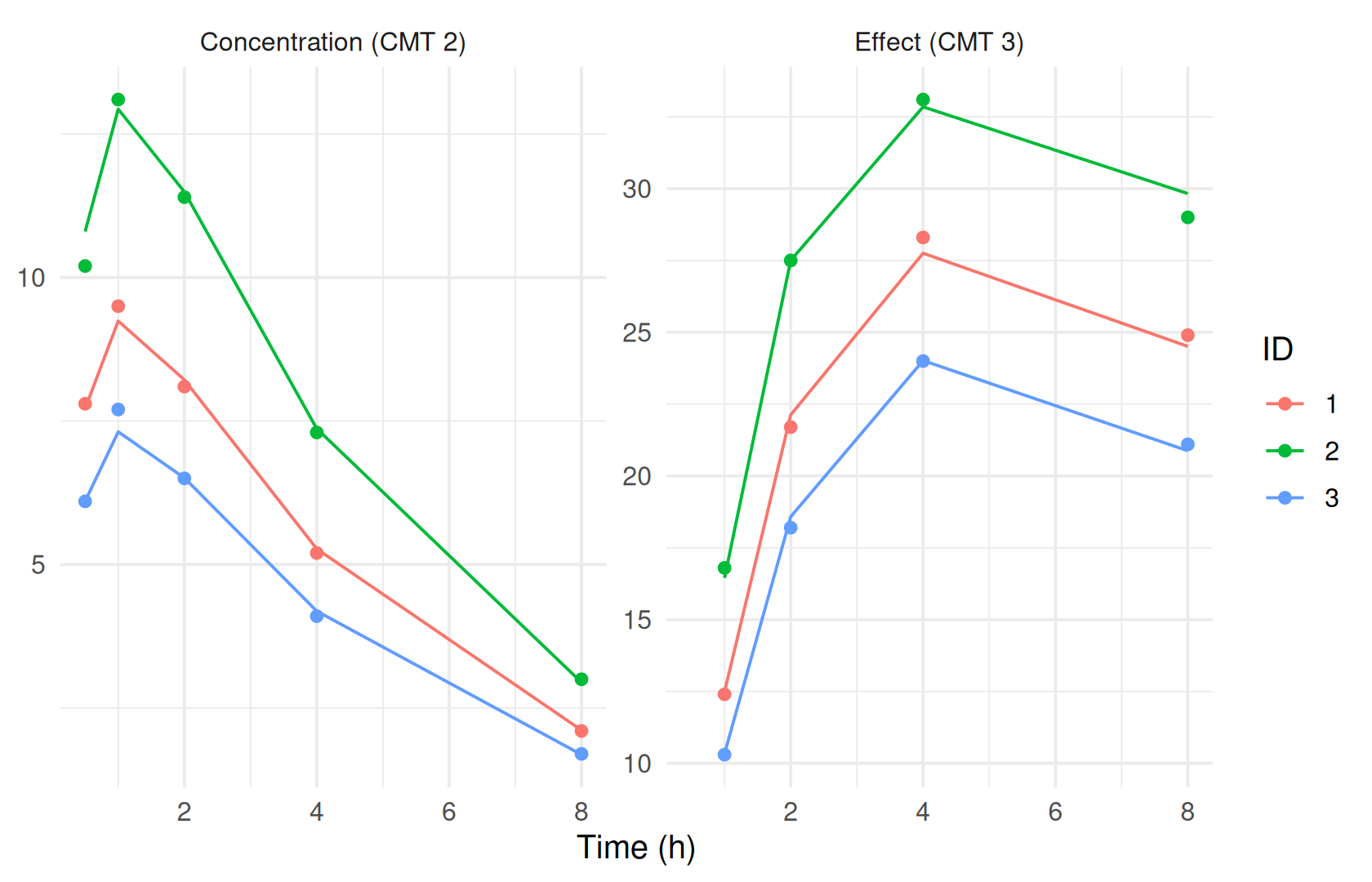

Figure 20.1: Joint PK/PD fit: observations (points) and individual predictions (lines) by endpoint.

The predictions follow the data, but three subjects cannot determine eight structural parameters and two residual errors:

fit_pkpd$estimates[, c("estimate", "rse_pct")]
#>                  estimate    rse_pct
#> TVCL         1.9732464647   2.170667
#> TVV          8.6426663276   2.259878
#> TVKA         2.3704024464   4.062792
#> TVKE0        0.2515138575   3.037510
#> TVE0         3.9603411889  55.674628
#> TVEMAX      42.9751711051  19.151999
#> TVEC50       3.8969463464  15.258605
#> TVGAMMA      1.4985026887  19.690190
#> ETA_CL       0.0012050321 102.814704
#> ETA_V        0.0008856919  98.185238
#> PROP_ERR_PK  0.0274070840  30.057275
#> ADD_ERR_PD   0.3874864042  24.786048
ferx_get_warnings(fit_pkpd, as_df = TRUE)[, c("severity", "category")]
#>   severity         category
#> 1  warning     inflated_rse
#> 2  warning high_correlation
#> 3 critical condition_number

The PD parameters have relative standard errors in the thousands of percent, and the parameters are almost perfectly correlated. The model structure is fine; the data are too few (see the simulation–estimation variant below).

Options that matter

Where Syntax Meaning
Data CMT on observation rows Which endpoint the row is
[structural_model] ode(states=[depot, central, effect]) No single obs_cmt; [scaling] defines each readout
[scaling] y[CMT=2] = central / V, y[CMT=3] = <expr> One readout per observed CMT
[error_model] CMT=2: DV ~ proportional(...), CMT=3: DV ~ additive(...) One residual error model per CMT (ODE models only)
[structural_model] y = <expr> with no pk or ode line A compartment-free model
[derived] EFF = EMAX * IPRED / (EC50 + IPRED) An effect computed from a PK fit

Every observed CMT needs a readout and an error model. The two forms cannot be mixed in one block (error model).

Variants

Simulation and estimation with more subjects

To see whether the joint model can be estimated with a realistic design, simulate a study from the model’s initial values and fit it again. The design has 30 subjects, six concentration samples and six effect samples each. ferx_simulate() without fit uses the model file’s parameters (Simulating scenarios):

ids <- 1:30
design <- bind_rows(
  data.frame(ID = ids, TIME = 0, DV = NA, EVID = 1, AMT = 100, CMT = 1, RATE = 0, MDV = 1),
  expand.grid(ID = ids, TIME = c(0.5, 1, 2, 4, 8, 12)) |>
    mutate(DV = NA, EVID = 0, AMT = NA, CMT = 2, RATE = 0, MDV = 0),
  expand.grid(ID = ids, TIME = c(1, 2, 4, 8, 12, 24)) |>
    mutate(DV = NA, EVID = 0, AMT = NA, CMT = 3, RATE = 0, MDV = 0)
) |> arrange(ID, TIME, desc(EVID), CMT)
design_file <- file.path(pkpd_dir, "pkpd_design.csv")
write.csv(design, design_file, row.names = FALSE, na = ".")
simulated <- ferx_simulate(pkpd$model, design_file, n_sim = 1, seed = 42)
#> Warning: ferx_simulate produced 1 diagnostic:
#>   W_DESIGN_DV: 360 observation row(s) (EVID=0) had a missing DV (`.`/`NA`/blank) and were kept as design points to simulate at. A fit of the same dataset would skip these rows (W_MISSING_DV), so the simulated dataset has more rows than the fitted one. Set MDV=1 on rows that are not sampling times.

The warning is expected for a design. The simulated values replace the empty DV column, matched by subject, time and CMT:

observations <- design$EVID == 0
design$DV[observations] <- simulated$DV_SIM[match(paste(design$ID, design$TIME, design$CMT)[observations],
                                                  paste(simulated$ID, simulated$TIME, simulated$CMT))]
simulated_file <- file.path(pkpd_dir, "pkpd_simulated.csv")
write.csv(design, simulated_file, row.names = FALSE, na = ".")
fit_simulated <- ferx_fit(pkpd$model, simulated_file, verbose = FALSE)
data.frame(parameter = c(names(fit_simulated$theta), fit_simulated$eta_names, fit_simulated$sigma_names),
           simulated_with = c(fit_simulated$theta_init, fit_simulated$omega_init[c(1, 4)], fit_simulated$sigma_init),
           estimate = c(fit_simulated$theta, diag(fit_simulated$omega), fit_simulated$sigma),
           rse_pct = fit_simulated$estimates$rse_pct)
#>      parameter simulated_with    estimate   rse_pct
#> 1         TVCL           5.00  5.17343599  6.001648
#> 2          TVV          50.00 46.37184848  5.730231
#> 3         TVKA           1.00  0.92644614  3.630840
#> 4        TVKE0           0.30  0.28826008  5.360423
#> 5         TVE0           2.00  1.99112637 13.112052
#> 6       TVEMAX          40.00 38.01602363 19.908078
#> 7       TVEC50           5.00  5.24771500 30.942874
#> 8      TVGAMMA           1.00  0.91037217  6.167395
#> 9       ETA_CL           0.09  0.10262928 25.020200
#> 10       ETA_V           0.09  0.08518941 26.593750
#> 11 PROP_ERR_PK           0.10  0.10205285  6.353595
#> 12  ADD_ERR_PD           1.00  0.98064460  5.502101

With 30 subjects all parameters are recovered with moderate standard errors. The simulated_with column is the model file’s initial values, which the simulation used and the fit started from.

Effects computed from a PK fit

When the PD parameters are known, an effect can be computed from the PK predictions without PD data. warfarin_derived_pkpd fixes EMAX, EC50 and a minimum effective concentration MEC as thetas and uses them in [derived]:

derived_pkpd <- ferx_example("warfarin_derived_pkpd")
invisible(ferx_model_get_section(derived_pkpd$model, "derived"))
#> # [derived]
#>   KE     = CL / V
#>   T_HALF = 0.6931472 / KE
#>
#>   # Emax PD effect at current concentration
#>   EFF    = EMAX * IPRED / (EC50 + IPRED)
#>
#>   # TAD-gated Cmax: peak within the current dosing interval
#>   CMAX_INTERVAL = max(IPRED, TAD < 24)
#>
#>   # Time above MEC per dosing interval (hours)
#>   TAM_TAU = integral(1.0, IPRED > MEC, window=24, anchor=0, step=0.1)
#>
#>   # Time above MEC on day 1 specifically
#>   TAM_D1  = integral(1.0, IPRED > MEC, from=0, to=24, step=0.1)
fit_derived <- ferx_fit(derived_pkpd$model, derived_pkpd$data, verbose = FALSE)
#> Warning in .ferx_compute_cor_matrix(result$cov_matrix): One or more diagonal
#> elements are non-positive; correlation matrix may not be meaningful.
filter(fit_derived$sdtab, ID == 1) |> select(TIME, IPRED, EFF, CMAX_INTERVAL, TAM_D1)
#>     TIME     IPRED      EFF CMAX_INTERVAL TAM_D1
#> 1    0.5  5.351751 51.26351      11.38329     24
#> 2    1.0  8.283413 58.72984      11.38329     24
#> 3    2.0 10.708454 62.49256      11.38329     24
#> 4    4.0 11.383285 63.31396      11.38329     24
#> 5    8.0 10.757785 62.55533      11.38329     24
#> 6   12.0 10.069303 61.63636      11.38329     24
#> 7   24.0  8.254797 58.67576      11.38329     24
#> 8   48.0  5.547784 51.92255      11.38329     24
#> 9   72.0  3.728488 44.33077      11.38329     24
#> 10  96.0  2.505797 36.40958      11.38329     24
#> 11 120.0  1.684066 28.76246      11.38329     24

The fixed thetas are used only in [derived], so the fit warns that they do not affect the predictions. That is intended here. With MEC = 0.5 every concentration in these data is above the MEC, so the time above it is the whole day. A copy with MEC = 8 shows a threshold within the concentration range, per 24-hour window:

mec8_model <- file.path(pkpd_dir, "warfarin_derived_pkpd_mec8.ferx")
writeLines(sub("theta MEC(0.5)", "theta MEC(8.0)", readLines(derived_pkpd$model), fixed = TRUE), mec8_model)
fit_mec8 <- ferx_fit(mec8_model, derived_pkpd$data, verbose = FALSE)
#> Warning in .ferx_compute_cor_matrix(result$cov_matrix): One or more diagonal
#> elements are non-positive; correlation matrix may not be meaningful.
filter(fit_mec8$sdtab, ID == 1) |> select(TIME, IPRED, TAM_TAU, TAM_D1)
#>     TIME     IPRED TAM_TAU TAM_D1
#> 1    0.5  5.351751    23.2   23.2
#> 2    1.0  8.283413    23.2   23.2
#> 3    2.0 10.708454    23.2   23.2
#> 4    4.0 11.383285    23.2   23.2
#> 5    8.0 10.757785    23.2   23.2
#> 6   12.0 10.069303    23.2   23.2
#> 7   24.0  8.254797    12.0   23.2
#> 8   48.0  5.547784     NaN   23.2
#> 9   72.0  3.728488     NaN   23.2
#> 10  96.0  2.505797     NaN   23.2
#> 11 120.0  1.684066     NaN   23.2

Subject 1 is above 8 for most of the first day and about half of the second. From day 3 on its concentration stays below 8, and the time above the MEC in those windows is reported as NaN, not 0. Treat NaN as “never above” when you summarise it.

Models without compartments

A response that is a plain equation of time, dose or other data needs no compartments. emax_timecourse writes the prediction directly in [structural_model]: EFF is an intermediate and y is the prediction. The dataset has no doses:

timecourse <- ferx_example("emax_timecourse")
invisible(ferx_model_get_section(timecourse$model, "structural_model"))
#> # [structural_model]
#>   # No `pk ...` and no `ode(...)` line: this block declares the prediction
#>   # directly. `EFF` is a named intermediate; `y` is the prediction.
#>   EFF = EMAX * TIME / (ET50 + TIME)
#>   y   = E0 - EFF
head(read.csv(timecourse$data, na.strings = "."), 3)
#>   ID TIME      DV MDV
#> 1  1  0.0 19.7922   0
#> 2  1  0.5 17.3779   0
#> 3  1  1.0 17.0081   0
fit_timecourse <- ferx_fit(timecourse$model, timecourse$data, verbose = FALSE)
fit_timecourse$estimates[, c("estimate", "rse_pct")]
#>           estimate   rse_pct
#> TVE0   10.20386741  5.609318
#> TVEMAX  5.91764644  1.708437
#> TVET50  2.09943732  6.894366
#> ETA_E0  0.09235685 25.923744
#> ADD     0.48045191  4.878111

Such a model works with prediction, simulation and the diagnostics like any other. TAD and TAFD are NaN in sdtab, since there are no doses. For the same reason ferx_predict() passes on the data reader’s W_NO_DOSES warning, which for a compartment-free model states the design rather than a problem:

head(fit_timecourse$sdtab, 3)
#>   ID TIME      DV      PRED    IPRED       CWRES      IWRES  EBE_OFV N_OBS TAFD
#> 1  1  0.0 19.7922 10.203867 19.28424  1.77662386  1.0572623 9.328104     8  NaN
#> 2  1  0.5 17.3779  9.065612 18.14598 -0.87930217 -1.5986637 9.328104     8  NaN
#> 3  1  1.0 17.0081  8.294603 17.37497 -0.04423527 -0.7635968 9.328104     8  NaN
#>   TAD
#> 1 NaN
#> 2 NaN
#> 3 NaN
ggplot(fit_timecourse$sdtab, aes(TIME)) +
  geom_line(aes(y = DV, group = ID), alpha = 0.2) +
  geom_line(data = ferx_predict(timecourse$model, timecourse$data, fit = fit_timecourse) |> distinct(TIME, PRED),
            aes(y = PRED), linewidth = 1) +
  labs(x = "Time", y = "Response")
#> Warning: ferx_predict produced 1 diagnostic:
#>   W_NO_DOSES: parsed zero dose events across all 30 subject(s) although scored observations are present. If this is a PK model, check that the dataset has an AMT column with EVID=1/4 dose rows (or a nonzero AMT when EVID is absent).

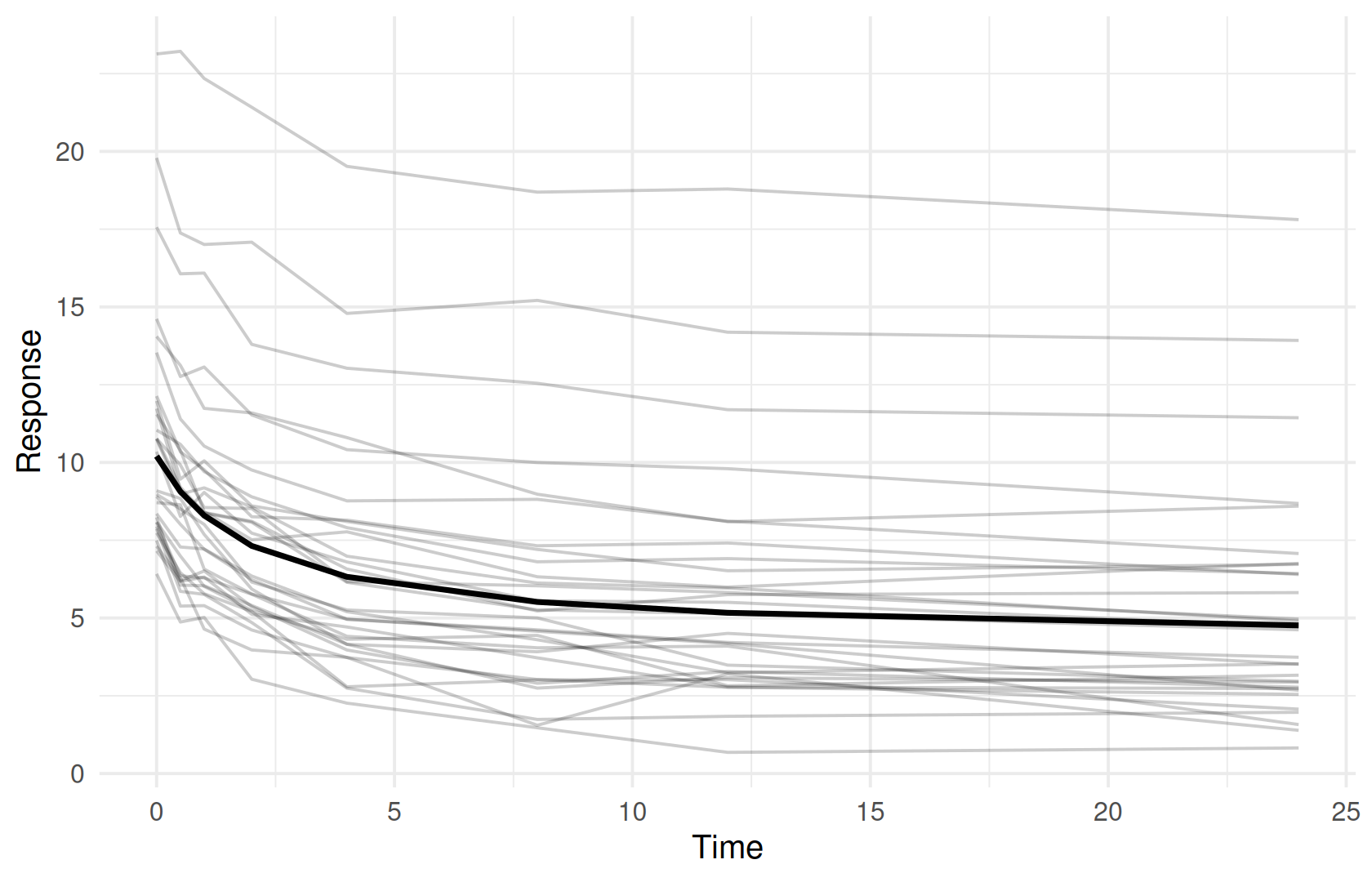

Figure 20.2: Compartment-free Emax time-course: observations (points) and the typical prediction (line).

A compartment-free model cannot have [odes], [scaling] or references to central and depot. y[CMT=N] gives it several endpoints (structural model).

Pitfalls

  • Joint PK/PD models need data for every parameter. Check relative standard errors and correlations before interpreting PD parameters; a simulation–estimation run tells whether a design can support the model.
  • Per-CMT error models need an ODE model. An analytical pk model with CMT=N: lines is rejected. Use ode_template to write the PK part as ODEs.
  • Every observed CMT needs a readout and an error model. A missing entry stops the fit and names the compartment.
  • Thresholds that are never crossed give NaN in [derived] filters and conditional integrals.

Warnings you may see here

  • general (warning): parameters declared but not used by the predictions, such as the fixed PD thetas of warfarin_derived_pkpd that only [derived] reads.

Other warnings above (inflated_rse, high_correlation, condition_number, covariance_regularized) are covered in Parameter uncertainty.

Summary

  • Put all endpoints in one dataset and tell them apart with CMT.
  • Write the PK and PD states as ODEs, one [scaling] readout and one error model per CMT, and fit them jointly.
  • Check with simulation and estimation whether a design can support the PD parameters.
  • Compute effects from a PK fit with [derived] when the PD parameters are known.
  • Write responses that are plain equations as compartment-free models.

Next: Binary endpoints covers binary endpoints.

TipReference
